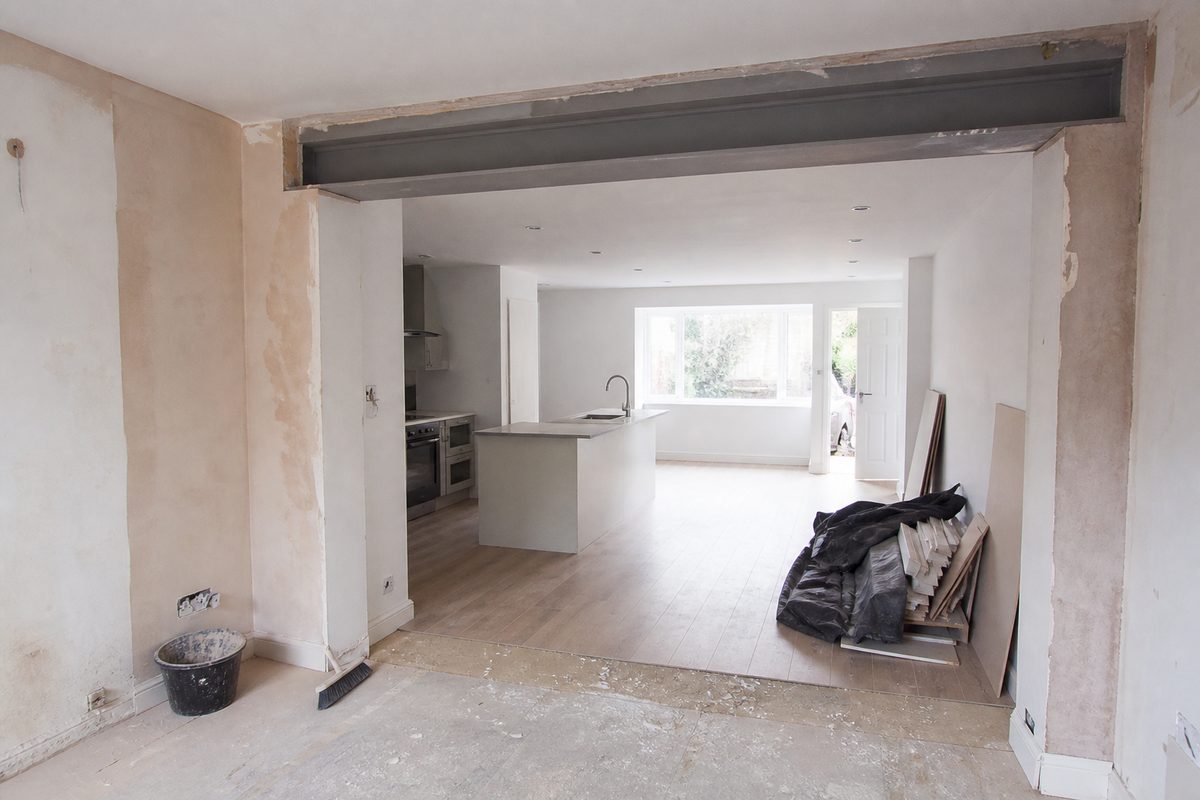

Case Study: Kitchen Knock-Through with an RSJ (UK Home)

This is a composite case study drawn from patterns we see repeatedly in UK terrace and semi knock-throughs. Names and addresses stripped. Numbers are rounded planning figures, not a promise that your quote will match. The point is the sequence and the decisions that usually bite homeowners — not a glossy before/after.

If you are still choosing a size, read the 4 m span guide and try the beam size calculator for questions to ask your engineer — not as a substitute for calculations.

The brief

Homeowners wanted a single kitchen-diner. Existing masonry wall between kitchen and rear reception. Clear opening target about 4.0 m. Two-storey house, timber floors above, no roof load sitting on that particular wall. They had already collected Pinterest photos. They had not measured bearings or thought about temporary works.

Early online reading pointed them at “203×133×25 for 4 m”. That is a common planning conversation, not a design certificate.

What the engineer asked for

  • Measured survey of the wall, floors and nearby openings
  • Trial holes near proposed bearings to understand foundations
  • Confirmation of joist directions and load width
  • Party wall awareness — neighbour chimney breast close to one bearing
  • Finish types upstairs (plasterboard vs older lath) because deflection tolerance matters

After calcs and serviceability checks, the issued drawing used a 254×146×31 with specified padstones, fire encasement and a clear temporary works note. The jump from the internet’s favourite 203 section is normal once load width and finishes are taken seriously.

Temporary works — the part people underquote

Before the wall came out, the contractor installed props and needles as drawn. That week felt slow to the owners. It was the cheap week compared with emergency propping after a DIY cut.

If your quote skips temporary works detail, ask again. Related reading: how to support an RSJ during installation and common installation mistakes.

Timeline (compressed)

WeekWhat happened
1–2Engineer appointment, survey, party wall letters started
3–4Calculations, drawings, Building Control application
5Steel ordered — cut length ~4.3 m after bearings
6Temporary works, wall removal, beam in, padstones checked
7–8Fire encasement, first-fix plaster, inspections
9+Making-good and kitchen fit-out (separate budget)

Not a one-weekend job. Anyone selling “beam in Saturday, dinner party Sunday” is selling a story.

Cost shape (rounded, structure-focused)

ItemApprox.
Engineer + drawings£700
Building Control£350
Steel + delivery£450
Labour / temporary works£1,600
Padstones / bedding£120
Making-good (not full kitchen)£1,200
Structure-focused total~£4,400

Fit-out units, flooring and appliances sat in another budget. For planning ranges on other jobs, see how much to install an RSJ and the cost calculator.

Steel £/m context: RSJ sizes and prices UK 2026.

What went well

Clear brief to the engineer. Props designed, not improvised. Padstones placed and levelled before the lift — see padstone size guide. Owners used site tools only to prepare questions:

They did not override the drawing with a forum thread.

What nearly went wrong

First steel quote used the wrong cut length — forgot bearings. Caught against the drawing. Order length ≈ clear span + bearing each end; the tool that would have caught it earlier is the bearing length calculator.

Second near-miss: a decorator wanted to remove props “to paint”. No. Props stay until sign-off.

Building Control touchpoints

Notifications before opening up, inspection of bearings/padstones as required by the authority, and completion paperwork. The calculator printouts were useful for the owners’ understanding. They were not submitted as structural evidence.

Lessons for the next reader

  1. 4 m openings often start at 203×133 talk and finish elsewhere.
  2. Budget making-good early — cracked ceilings and flooring junctions cost real money.
  3. Party wall delays are calendar delays, not optional admin.
  4. Tools help planning; drawings rule the site.
  5. Padstones and temporary works are not “extras”.

More depth on the opening type: knocking through a wall · kitchen extension RSJ.

FAQ from this job

Why did the beam get bigger than the first guess?

Deflection and load width. Strength looked “okay” on a napkin; stiffness and finishes did not.

Could they have used two smaller beams?

Sometimes. Here the engineer preferred one mark for the opening. Layout-dependent — not a DIY choice.

Did they need a crane?

Telehandler access from the rear garden was enough for this mass. Check yours with the weight calculator before delivery day.

Communication that helped

Weekly photo updates to the engineer when bearings were opened. Written confirmation of steel marks before fabrication. A single site drawing pack so plasterers did not invent pocket details.

Compare loft complexity in the loft steels case study � more marks, same need for schedule discipline.

Bottom line

A kitchen knock-through is a project with engineering, temporary works, steel logistics and making-good — not a shopping trip for one beam. Use calculators to ask better questions. Use an engineer to design. Use Building Control to close it out legally.

James Hartley

About James Hartley

Editorial Lead

Construction content editor focused on clear, practical guides for homeowners and builders planning RSJ projects across the UK.

RSJ.info is an independent editorial site. Our guides and calculators are for planning only and do not replace advice from a chartered structural engineer or Building Control approval. Meet the team →
